The industrial landscape in Vietnam is moving beyond simple energy bill reduction. Since the retail electricity price adjustment in May 2025—which saw average rates climb to approx. 2,204 VND/kWh—the narrative for manufacturing hubs in Binh Duong and Bac Ninh has shifted toward long-term asset security. The focus for B2B investors and EPC contractors has moved beyond module efficiency to a more fundamental engineering challenge: How do we secure a 25-year structural guarantee in a high-wind typhoon corridor?
The proposed 2026 amendments to Decree 57 represent a bold transition toward grid-parity solar. By doubling the potential for surplus monetization, the draft framework effectively allows factory owners to generate predictable secondary income from underutilized roof space.
| Metric | Previous Surplus Regime | Proposed 2026 Framework |
|---|---|---|
| Surplus Export Cap | Strictly 20% of capacity | Up to 50% of output (Proposed) |
| Pricing Basis | Static / Negotiated | Prev. Year VCGM Average (Proposed) |
| Administrative Flow | Formal Permission Needed | Trend toward Simplified Notification |
| BESS Priority | Not specified | Potential advantages for storage |
Our financial models suggest that these changes can lift project Internal Rate of Return (IRR) by 3–5 percentage points in typical industrial configurations. In Southern Vietnam hubs, this reduces the payback period significantly, as higher irradiation levels maximize the value of every exported kWh.
In our experience, the first thing local lenders now request is not the panel datasheet, but the Professional Structure Analysis Report. As grid connections require higher technical transparency, the mounting system has evolved into the guarantor of cash flow.
Based on installation records from 2023–2025, we have standardized industrial production on AL6005-T5. This alloy provides a critical resilience edge in tropical climates:
Coastal zones like Hai Phong and Vung Tau are high-salinity marine environments. Step 8 of Ziyuan Solar’s proprietary 11-step production involves advanced Anodizing Oxidation.
'Our project engineering team in Vietnam observed brackets with standard 10μm coatings showing pitting in under 36 months near coastal sites. Ziyuan’s industrial standard of 15–20μm, which passes the 336-hour Neutral Salt Spray (NSS) test, is the baseline for projects targeting a 25-year lifespan.' — Strategic Advisory Team, Ziyuan Solar.
In practical JIS C 8955:2017 design, our engineers calculate the design wind load (W) using the product of the wind force coefficient (Cw), velocity pressure (q), and windy area (Aw):
During the 2025 storm season, we saw that sites engineered strictly to the 60m/s case survived with only minor clamp retightening. Conversely, systems that ignored localized suction effects at roof edges frequently experienced row failures.

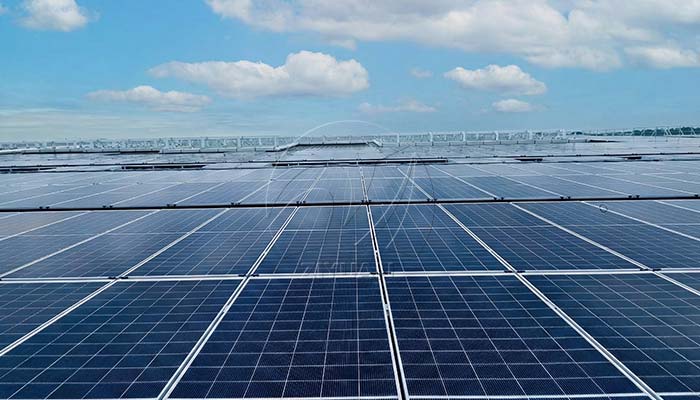

Reaching the Commercial Operation Date (COD) as early as possible is a financial imperative. Our real-world data from a 3MWp rooftop project in VSIP Binh Duong illustrates the time-saving gap:
B2B buyers now compare solutions by their impact on Levelized Cost of Energy (LCOE). The LCOE is the total lifecycle cost (CapEx + OpEx) divided by the total lifetime energy yield:
With a growing share of Vietnam's C&I installs shifting to Bifacial Modules, our slim-profile rail designs minimize backside shading. This can deliver a 10–20% albedo gain from reflective roofs, effectively lowering the LCOE by several mills per kWh.
Q: How do you handle legacy roofs with uncertain load capacity?
We recommend a three-stage assessment: First, determine the load-bearing baseline; second, apply non-penetrating ballasted bases to spread loads evenly (~15–16 kg/m²); and third, utilize AL6005-T5 to keep dead weight low.
Q: Are export-limiting or Zero-Export devices mandatory?
In many provinces, distribution utilities require limiters if your surplus exceeds 50%. Owners should confirm local requirements before finalizing electrical design.
Q: Does storage improve IRR under the current policy direction?
While exact mechanisms are evolving, the direction is increasingly friendly toward storage. Hybrid systems can materially improve project economics during evening peaks.
The proposed changes to Decree 57 have opened a definitive window for maximizing solar profits in Vietnam. Whether you are seeking an Aluminum Solar Carport for parking or a Quick-Mount Ballast system, your choice of structure is the silent guarantor of your 25-year income.
